Chelmer residents and travellers using the Walter Taylor Bridge are facing further weekend closures and changed travel arrangements as essential maintenance continues on the long-standing river crossing to Indooroopilly.
The works centre on the replacement of structural nodes, the steel connection points that link the bridge’s cables to its truss. These parts have reached the end of their service life and are being replaced to help keep the bridge safe, stable and reliable for future use.
Because the replacement process requires the bridge to carry no load, the crossing has been closing fully across selected weekends. The closures apply to vehicles, pedestrians, cyclists and emergency vehicles, with detours in place across the river and through nearby streets.
Chelmer Travel Changes Continue During Bridge Works
The Walter Taylor Bridge was listed for full closures from 9pm Friday 22 May to 5am Monday 25 May and from 9pm Friday 29 May to 5am Monday 1 June.
Further full closures are scheduled from 9pm Friday 5 June to 5am Monday 8 June and from 9pm Friday 19 June to 5am Monday 22 June.
The bridge may reopen earlier if scheduled work is completed ahead of time and the crossing is safe to use. Closure dates and times may also change depending on weather and work conditions.
For Chelmer motorists, the closures mean extra planning before crossing the river or moving through the local area. Wharf Street closes between Rosebery Terrace and Regatta Street, while Radnor Street closes between Foxton Street and Riverview Terrace during full bridge closures.

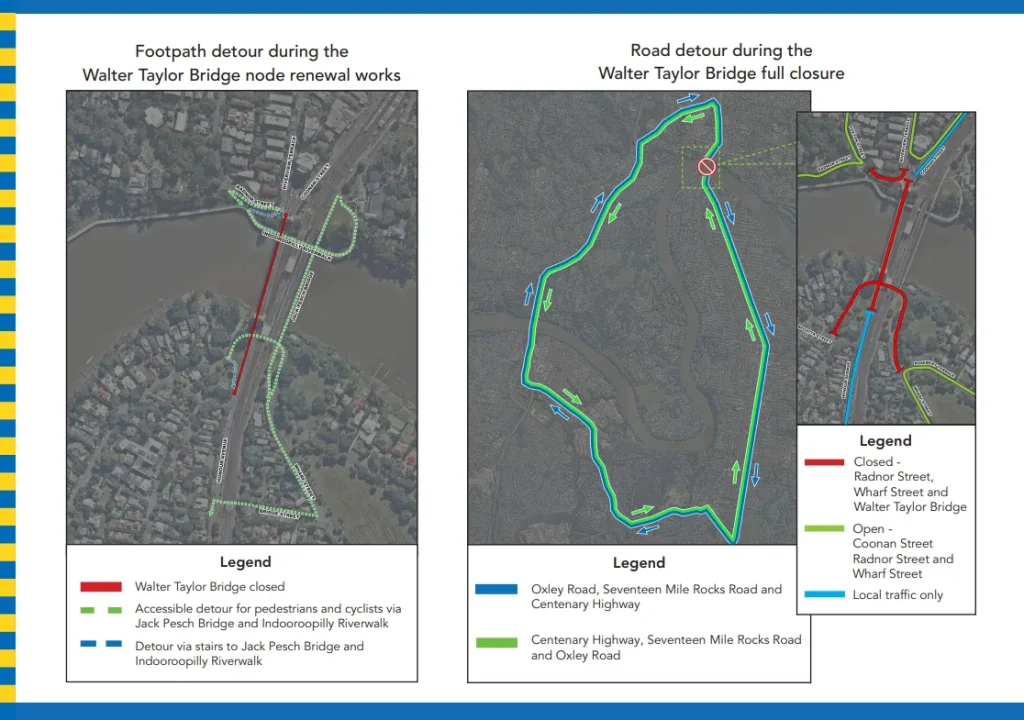

Traffic control and signage are being used to guide road users through the changed conditions. Listed detour routes include Oxley Road, Seventeen Mile Rocks Road and the Centenary Highway, with motorists advised to allow extra travel time.

Footpath Closure Has Shifted Crossings to Jack Pesch Bridge
The Walter Taylor Bridge footpath closed from late April 2026 and is set to remain closed until the works are complete. Pedestrians and cyclists travelling from the Chelmer side are being directed to use Jack Pesch Bridge and the Indooroopilly Riverwalk during this period.
Accessible detour options are also available for pedestrians and cyclists. Wayfinding and signage are being used to direct bridge users through the altered routes.
The change is most noticeable for people who usually rely on the Walter Taylor Bridge for short local trips between Chelmer and Indooroopilly, including commuters, walkers and cyclists crossing the river.
Bus Passengers Face Train Transfers
Public transport users in Chelmer and nearby suburbs are also affected during the full closure weekends. Bus routes 105, 106, 127, 598 and 599 are impacted, with temporary bus stop changes in place.
Passengers travelling across the river need to get off on either side of the bridge, use a train to cross, then continue their journey by bus. Service updates are available through Translink channels.
Emergency vehicles responding with lights and sirens may use the nearby Jack Pesch Bridge during the closure periods, with traffic control managing access when required.

Overnight Works Add Further Local Delays
Separate overnight lane closures have been taking place from late April to support scaffold installation. These closures run from 9pm to 5am, Sunday to Thursday.
Similar overnight arrangements are expected from mid-June for scaffold removal. Traffic continues in both directions under stop/go control during these night works, although delays are expected.
Nearby residents and businesses may notice increased noise and lighting during work hours. The scaffold installation is part of the wider renewal program, which includes inspection, repair and replacement of key bridge components.
A Longer Renewal Program for the Chelmer–Indooroopilly Link
The Walter Taylor Bridge has connected Chelmer and Indooroopilly since it opened on 14 February 1936. First known as the Indooroopilly Toll Bridge, it was renamed in honour of Walter Taylor in 1956.
The bridge uses surplus suspension cables from the Sydney Harbour Bridge project and includes two reinforced concrete towers. Its north tower was used for residential living for more than 75 years until 2009, making the crossing one of Brisbane’s more unusual heritage-listed structures.

Photo Credit: BCC
The wider renewal program includes repairs to the rendered façades of the north and south towers, updated protective coatings, detailed inspections and further maintenance. Investigation and trial works began in February 2026, with node renewal works and weekend bridge closures continuing across May and June 2026.
North tower façade renewal works are listed from mid-2026, with further node and maintenance works planned in later stages. South tower façade renewal works are listed for mid-2027, and tower façade works are expected to continue through to mid-2028.
The immediate impact remains weekend road closures, footpath changes and altered bus connections. The broader purpose is to keep the Walter Taylor Bridge safe and reliable while preserving its role as a key river crossing between Chelmer and Indooroopilly.
